27 July 2023 - Upsy daisy


Extract only ventilation systems tend to be easily validated in the ventilation validation scheme by NSAI. As long as the flow rates meet the minimum requirements, that currently is about the only thing that will give trouble. There is the odd case of no operation or fault light, no ductwork insulation, or as per the previous few notes in this blog, register placement and machine installation, but apart from that, the flow rates are the main concern.

A recent case involved 4 houses that needed the validation procedure to allow closing. 3 of the 4 had the expected flow rates, one of the houses had the expected flowrates in all of the registers, bar one. That one register had a very low flow.

How was that register was allowed to pass the commissioning step? ... well in a way, that is why the validation procedure is being done.

Luckily, the person who did the commissioning was still on site, so together we checked the ductworks, the machine etc; and found this:

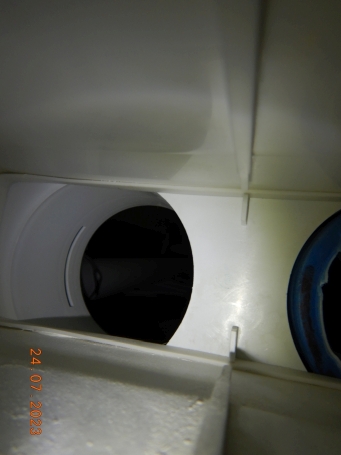

Example of vent register where the connection box in the ceiling allows for 2 connections, but only one being used. The other one should have been bunged - but in this case it was not.

If it is not evident, this is a connection box in the ceiling, with 2 connection holes, only one of which is being used (on the right). The other one should have a bung in it, but doesn't, so the planned airflow pathway is much disturbed.

Fortunately, someone with small hands was able to fix a bung even into the connection box, the system was re-balanced and balance was restored.


31 Jan 2023 - 2022 in Airtightness, brief overview


Just for interest: the best and worst tests of the year in 2022

Best Air Permeability test Worst Air Permeability tested

New build

Worst Air Permeability tested

Existing

1 0.285 - timber frame single home 16.38 - new offices, would normally have been expected to be less than 5. 24.44 - offices about to be renovated
2 0.425 - timber frame single home 8.50 - detached block house 15.54 - single home, cold in home survey
3 0.455 - timber frame single home 8.36 - terraced house. A painted airtightness layer was used mainly, but the high test number was due to areas where this layer simply was not present 14.30 - single home, cold in home survey

The three best results are all from the same timber frame supplier. The best we tested that was not from them was q50 of 0.62 m3/hr.m2 on a 2 storey city CLT house.
By the way, where the test is over the allowed limit, there is typically a retest on another day, following rectification works. We do not report on that here.



  Current Year
Previous Blog Entries...
2022 2021 2020 2019 2018 2017 2016 2015 2014 2013 2012

Airtightness testing - IS EN9972:2015 Certified Member of the Irish Passive House Association


Greenbuild Energy Rating and Building Information Services Ltd trading as
GreenBuild
Gorey, Co. Wexford
Tel: 087 2521032   contact@greenbuild.ie
All information presented here is without warranty or guarantee.
